P R O G R E S S    O N    S I T E

The Saffron at Sentul East
Construction Progress
September 2007

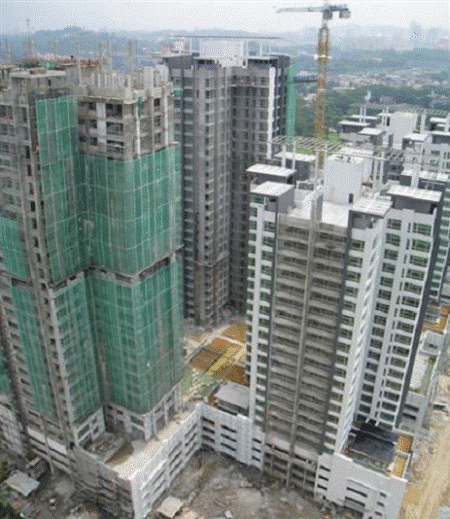

An aerial view of the project site.

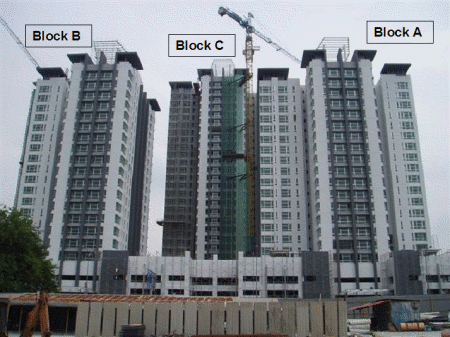

A close view of Block A, B and C.





 Block A
 Level 6 to 21

  • Floor board in progress from Level 10 to Level 26
  • Floor screed completed
  • Wall & floor tiling completed
  • Internal skim coating completed
  • External wall plastering completed
  • Internal painting : Finish coat 80%completed
  • External painting in progress
  • Window glazing in progress
  • Sanitary ware installation in progress
  • Plaster ceiling completed


 Block B
 Level 6 to 21

  • Floor screed completed
  • Wall & floor tiles completed
  • Internal wall plaster completed
  • Internal skim coating completed
  • External wall plastering completed
  • Internal painting : Finish coat in progress
  • External painting completed
  • Window glazing : 90% completed
  • Sanitary ware installation : 90% completed
  • Level 5 : Aluminium outer frame completed
  • Plaster ceiling completed


 Block C
 Structural Works

  • Typical floor completed
  • Upper roof completed
 Architectural Works
 Level 5 to Level 28
  • ALC block laying completed
  • Floor screed completed
  • Wall & floor tiling completed
  • Internal wall plastering completed
  • Internal skim coating completed
  • External wall plastering : 95% completed
  • External wall painting : Finish coat completed
  • Aluminium outer frame completed
  • Window glazing in progress
  • Plaster ceiling : 80% completed
  • Sanitary ware installation in progress


 Block D
 Structural Works

  • Typical floor completed
  • Upper roof completed
 Architectural Works
 Level 6 to Level 28
  • Floor screed : Level 27 in progress
  • Wall & floor tiling : Level 28 in progress
  • Internal wall plastering : Level 28 in progress
  • Internal wall skim coating : Level 28 in progress
  • External wall plastering : 2nd stage in progress
  • Aluminium outer frame : Level 28 in progress
  • Window glazing in progress
  • Plaster ceiling : Level 27 in progress
  • Level 5 : ALC block completed
  • Level 5 : Aluminium frame in progress
  • Level 5 : Skim coating in progress

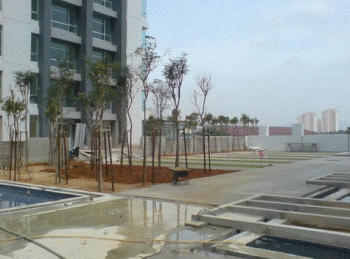

The pool deck is beginning to take final shape.

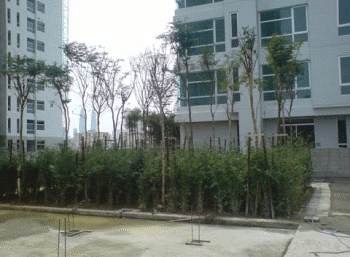

Landscaping works at various sections of the pool deck is well underway.

Construction Progress
April 2008
January 2008
September 2007
October 2007
April 2007
November 2006
